In Progress: Courtney Ave. Sewer Improvements Project

Project Overview

In February, sewer improvement construction will begin along Courtney Ave. between River Rd. and McLoughlin Blvd. Work is expected to be completed in the spring of 2026.

Purpose

Oak Lodge Water Services is replacing aging sewer mains along Courtney Ave. in Oak Grove.  As part of the project, lateral connections from the main line within the public right-of-way to individual property boundaries will also be replaced.

Clackamas County is planning road improvements on Courtney Ave. in the near future, which may affect access to our underground infrastructure. To avoid disruptions, we are completing this work ahead of the County’s project.

The result: Replacing and rehabilitating aging infrastructure minimizes recurring maintenance issues and reduces long-term repair costs.

A button with "Sign up for email updates" text on it.
Project Timeline Total Cost
February 2026 - spring 2026 $1,500,000
 Project  Contact  Phone Email
Ben Green  (971) 415-4953 ben.green@olws.org

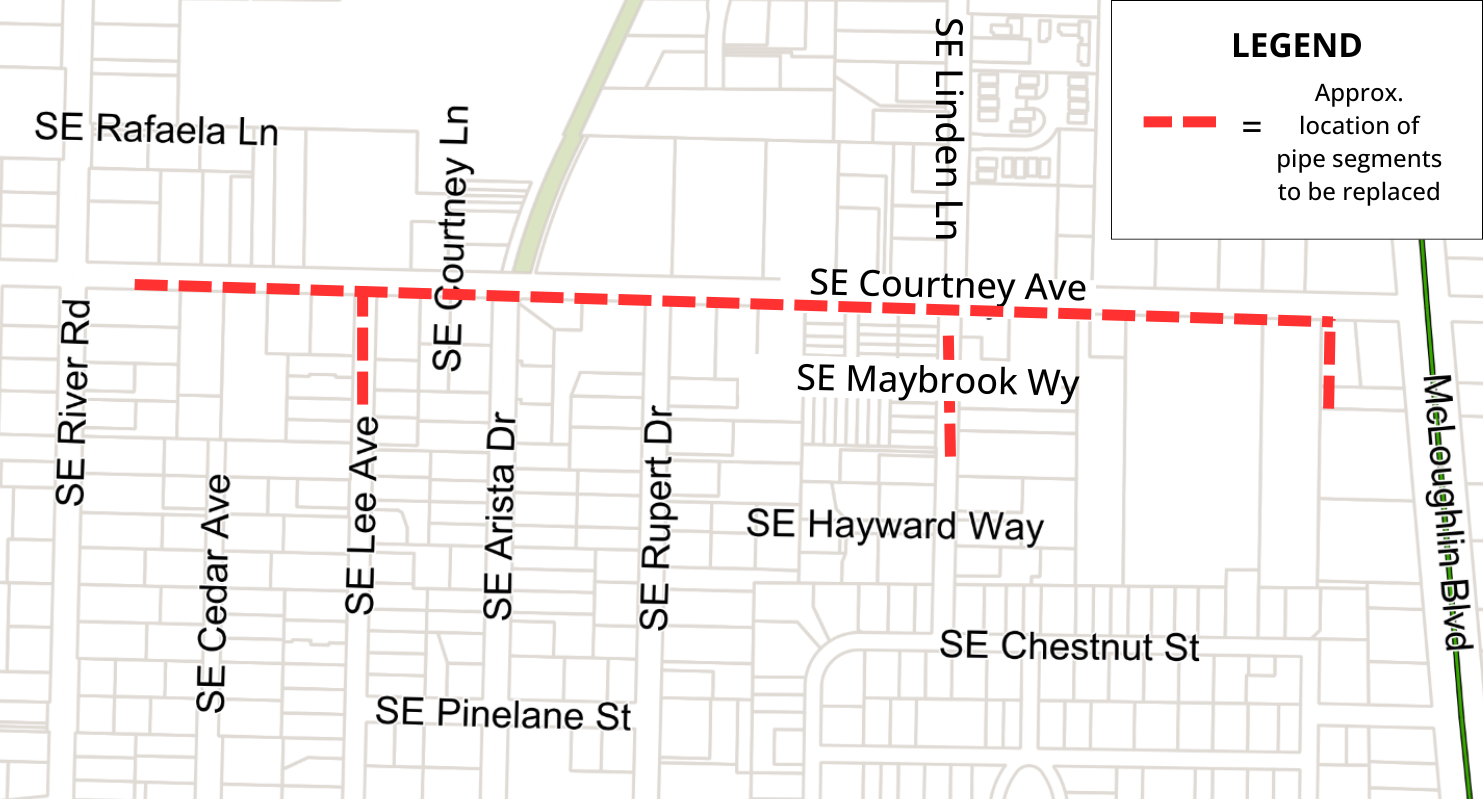

Map showing pipe segments to be replaced on SE Courtney Ave and nearby streets.



Potential Project Impacts

Work hours: Monday-Thursday, approximately 7 A.M. - 5 P.M.

Sections of Courtney Ave will be closed while pipe replacement work is underway. Detour signage will be on-site directing traffic around the work area (crews will work with residents to maintain local access). If you are driving, biking, or walking in the area, please be alert and watch for construction crews, construction signs, and flaggers.

During construction, heavy equipment and materials will be in the work area, which will be marked with cones and/or caution tape. There may also be some noise and dust during construction hours.

On-site crews will communicate directly with homeowners about any direct impacts.

If you're experiencing impacts beyond what's typical for construction, please contact us directly.

Project Schedule

Schedule Lookahead*

The pipe replacements occur in segments, with crews moving west to east on Courtney Ave. before moving to side streets. Each line of the schedule describes the general area of the pipe segment to be replaced. Please refer to the map or contact the project manager for more details.

The image depicts a map with dates and segments (C300-C310) along SE Courtney Ave, possibly for a project or survey schedule.
Click the map to enlarge.
Week of Location Planned Work Potential Impacts
 3/2 - 3/6 Courtney Ave. between approximately Rupert Dr. & Linden Ln. Pipe bursting and lateral replacements Courtney Ave. closed during work hours.<br><br> Crews to work with residents to maintain local access.
3/9 - 3/12 Courtney Ave. between approximately Linden Ln. & Courtney Rd. Pipe bursting and lateral replacements Courtney Ave. closed during work hours.<br><br> Crews to work with residents to maintain local access.
3/16 - 3/19 Courtney Ave. between approximately Courtney Rd. and 99E Pipe bursting and lateral replacements Courtney Ave. closed during work hours.<br><br> Crews to work with residents to maintain local access.

* Schedule is our best current estimate and is subject to change.

Private Improvements in Public Right-of-Way

In some locations, crews must work outside the public right-of-way in areas called easements or within undeveloped public right-of-way. Work crews will coordinate with homeowners with easements in or near their property.
